A 150 m river bridge, estimated from one drawing.

A detailed estimate for a high-level river bridge, priced on the Public Works Department's Schedule of Rates. We worked from one general arrangement drawing and sent the client the estimate the same day, with full workings and 23 clarifications.
Six 25 m spans
150 m
Bored piles
38
Estimate, incl. GST
~₹10 cr
Clarifications
23
Drawing to estimate
Same day
A six-span concrete river bridge on circular piers
THE KIND OF BRIDGE · SIX SPANS ON CIRCULAR PIERSILLUSTRATIVE IMAGE
W-01/THE BRIEFONE A1 DRAWING

Price it on the department’s schedule.

The client sent a single A1 general arrangement drawing, marked “not to scale”. We were asked to break the bridge into components, take off the quantities, price them on the Public Works Department’s Schedule of Rates, use the MoRTH Standard Data Book for anything the schedule doesn’t cover, and measure to MoRTH and IRC rules, with full workings so every line could be followed.

ElementFrom the drawing
Length150 m, six spans of 25 m
SuperstructureRCC T-beam and slab, four girders, 12 m deck
SubstructureCircular RCC piers; two RCC box abutments
Foundations38 bored cast-in-situ piles, 1,200 mm, socketed into rock, with a permanent steel liner
Bearings and jointsPOT-PTFE bearings; strip-seal expansion joints

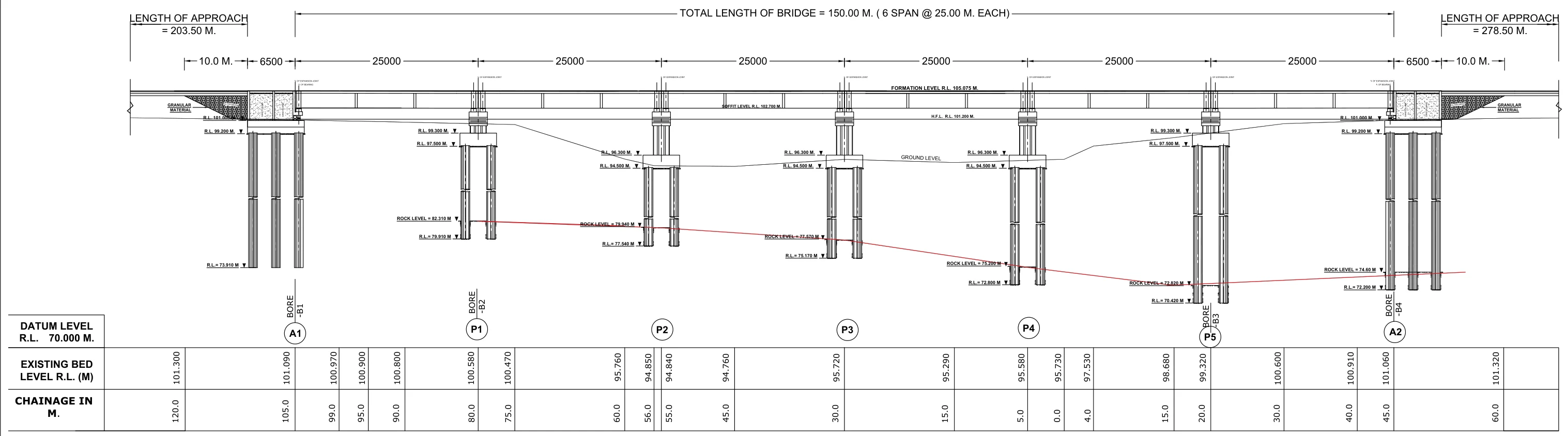

General arrangement drawing, longitudinal elevation: six 25 m spans on piers and box abutments, with bored piles socketed into rock
THE INPUT · GENERAL ARRANGEMENT, LONGITUDINAL ELEVATIONPROJECT DETAILS REDACTED
W-02/HOW WE DID ITAI PRODUCTION · ESTIMATOR CHECK
  1. 01

    Read the drawing

    Every dimension and level read, and the drawing checked against itself across its views.

  2. 02

    Found the rates

    The current Public Works Department bridge and road schedules located, with item numbers, rates and page references.

  3. 03

    Took off quantities

    Each quantity comes from a drawing value or a written assumption.

  4. 04

    Applied the measurement rules

    The MoRTH specifications decide how each item is measured for payment: piles from cut-off to toe, liner by weight.

  5. 05

    Built the estimate

    In departmental format: measurement sheets, steel abstract, rate sheet and an abstract in the schedule's own item wording, with live formulas throughout.

  6. 06

    Reviewed it four ways

    Drawing inputs re-read, rates and item mapping checked, quantities recomputed from scratch, and engineering completeness reviewed, in parallel.

  7. 07

    Checked by an estimator

    A practising estimator checked the maths before anything went to the client.

W-03/WHAT THE REVIEW CAUGHTBEFORE IT WENT OUT

What the review caught before it went out.

The reviews confirmed every drawing value, all 45 schedule rates with their item numbers and pages, and every formula. A from-scratch recompute matched every quantity. They still found issues that the first draft’s own checks had passed, all fixed in one revision before anything went out.

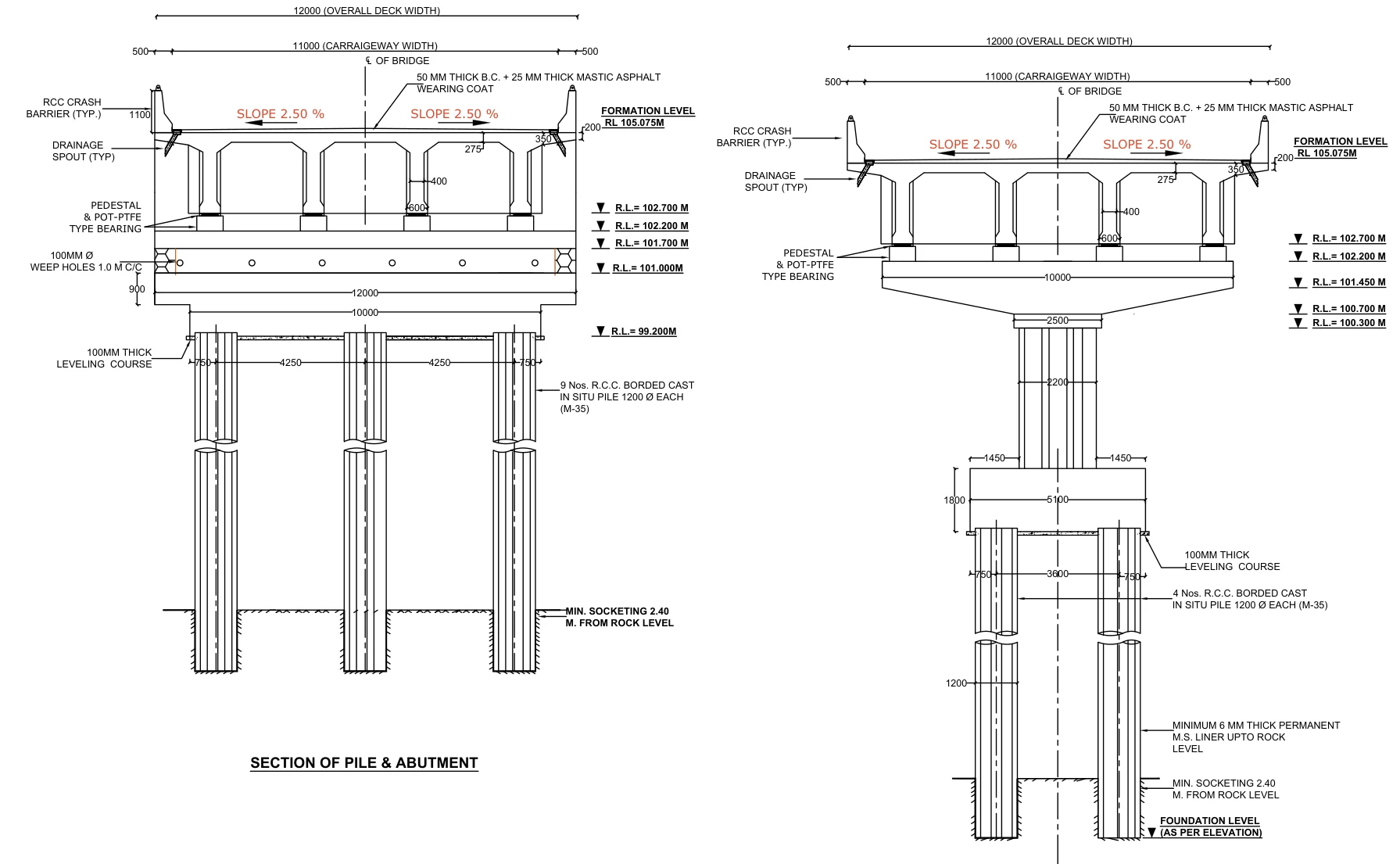

Sections through the pile and abutment, and the pile and pier, from the general arrangement drawing
SECTIONS THROUGH ABUTMENT AND PIER · SOURCE OF THE QUANTITIES
  • 01Backfill behind the abutments was under-measured by about 40%. The drawing dimensions a 10 m filter-media wedge that the first draft had read as a sloped layer.
  • 02The trial piles were missing their permanent liner.
  • 03Small double counts at girder ends, fillets and cross girders.
  • 04Pile reinforcement raised for piles standing free after scour, and the pile test load corrected to include braking.
  • 05Height bands applied one consistent way across piers and pile caps.
  • 06An item the draft had priced outside the schedule turned out to be in it.
W-04/WHAT THE DRAWING DIDN'T SAY23 CLARIFICATIONS

₹80 lakh+ in savings and risks, flagged before the tender.

The estimate went out with 23 clarifications, each with its cost effect. Conflicts in the drawing were logged rather than quietly resolved, including a pile cap dimensioned differently in plan and in side view, and two misprinted bore levels.

POTENTIAL SAVING~₹65 lakhThe drawing runs the steel liner down to rock. MoRTH 1107.3 only requires it to scour level.
POTENTIAL SAVING₹15–25 lakhIf one abutment's bore is weathered rock rather than sand, its piles can be socketed and shortened.
AT QUESTION~₹30 lakhMoRTH puts trial-pile installation inside the pile rate. Pricing it separately needs a tender condition.
UNCERTAINTY±₹35 lakhWith no bar bending schedule, steel was estimated from kg/m³ norms. This is the largest remaining uncertainty.
WHERE THE MONEY SITSSHARE OF WORKS AT SCHEDULE RATES
52%
38%
10%
Foundations 52%Superstructure 38%Substructure 10%

Foundations are about half the cost, because of the deep socketed piles and full-depth liner. Steel is the next biggest variable, so the bar bending schedule was the next job.

W-05/WHAT CAME NEXTTWO MORE JOBS

The client came back with more work.

The client was happy with the estimate and asked for two more pieces of work: a detailed estimate for the return and toe walls of a second bridge, and a bar bending schedule.
